How Long Does It Take to Build a Home in Pahrump, NV? (2026 Guide)



If you’re considering building a custom home in Pahrump, one of the first questions you’ll ask is: how long is this going to take? It’s a fair question — and one that deserves a straight answer rather than a vague “it depends.”

The short answer: most custom home builds in Pahrump run 6 to 10 months from signed contract to certificate of occupancy. That range is real, and the difference between six months and ten comes down to a few specific factors we’ll walk through below.

At Innovative Custom Homes, we’ve completed multiple builds in the Pahrump Valley — from our Jaybird and Carnation projects to our most recently completed home at 1671 Iguana Street. Here’s what the timeline actually looks like on the ground, phase by phase.

Phase 1: Pre-Construction and Permitting (4–8 Weeks)

Before a single shovel hits the ground, there’s paperwork — and in Nye County, the permitting process is a real part of your timeline. This phase covers everything from finalizing your floor plan and signing the build contract to submitting plans to the county and waiting for approval.

Nye County’s building department processes residential permit applications on a rolling basis. In our experience, straightforward single-family home permits typically take 4 to 6 weeks from submission to approval. More complex designs or plans that require revisions can push that to 8 weeks.

What happens during this phase:

  • Final floor plan selection and plan printing
  • Soils testing and site evaluation (if required)
  • Building permit application submitted to Nye County
  • Well permit application (if applicable)
  • Septic system design and permit application
  • Utility coordination

This is also when your construction financing gets finalized. If you’re using a construction-to-permanent loan, your lender will need the signed contract, approved plans, and a draw schedule before releasing funds. If you’re asking about financing options, our Build With Us page covers how we connect buyers with Nevada construction lending partners who know Pahrump.

Pro tip: The pre-construction phase is where delays most often originate — not during construction itself. Having your lot evaluation, floor plan decision, and financing lined up before you sign the contract shaves weeks off the front end.

Phase 2: Site Work and Foundation (3–5 Weeks)

Once permits are in hand, work begins on your lot. In Pahrump, this phase looks different than it does in Las Vegas suburbs — you’re typically working with a one-acre parcel, which means more site prep than a small subdivision lot.

Site work in Pahrump includes:

  • Grading and clearing — leveling the lot, removing brush and debris, establishing drainage
  • Well drilling — most Pahrump lots are on private wells. Depth varies significantly across the valley, from around 200 feet to over 600 feet depending on location. This is one of the most variable cost and time factors in a Pahrump build
  • Septic system installation — Pahrump is not on a municipal sewer system. Your septic design is based on soil percolation and household size
  • Utility trenching and electrical service — coordinating power service from NV Energy
  • Concrete slab pour — once the ground is prepped and plumbing rough-in is set under the slab

Weather matters here. Pahrump’s desert climate is generally favorable for year-round construction, but extreme heat in July and August can slow concrete pours and create challenges for workers. Winter is mild enough to build straight through in most years.

If you own land in the Pahrump Valley and are wondering what site work costs and involves for your specific parcel, our complete guide to building on your lot in Pahrump walks through the lot evaluation process in detail.

Typical duration: 3–5 weeks from permit issuance to slab completion.

Phase 3: Framing (3–4 Weeks)

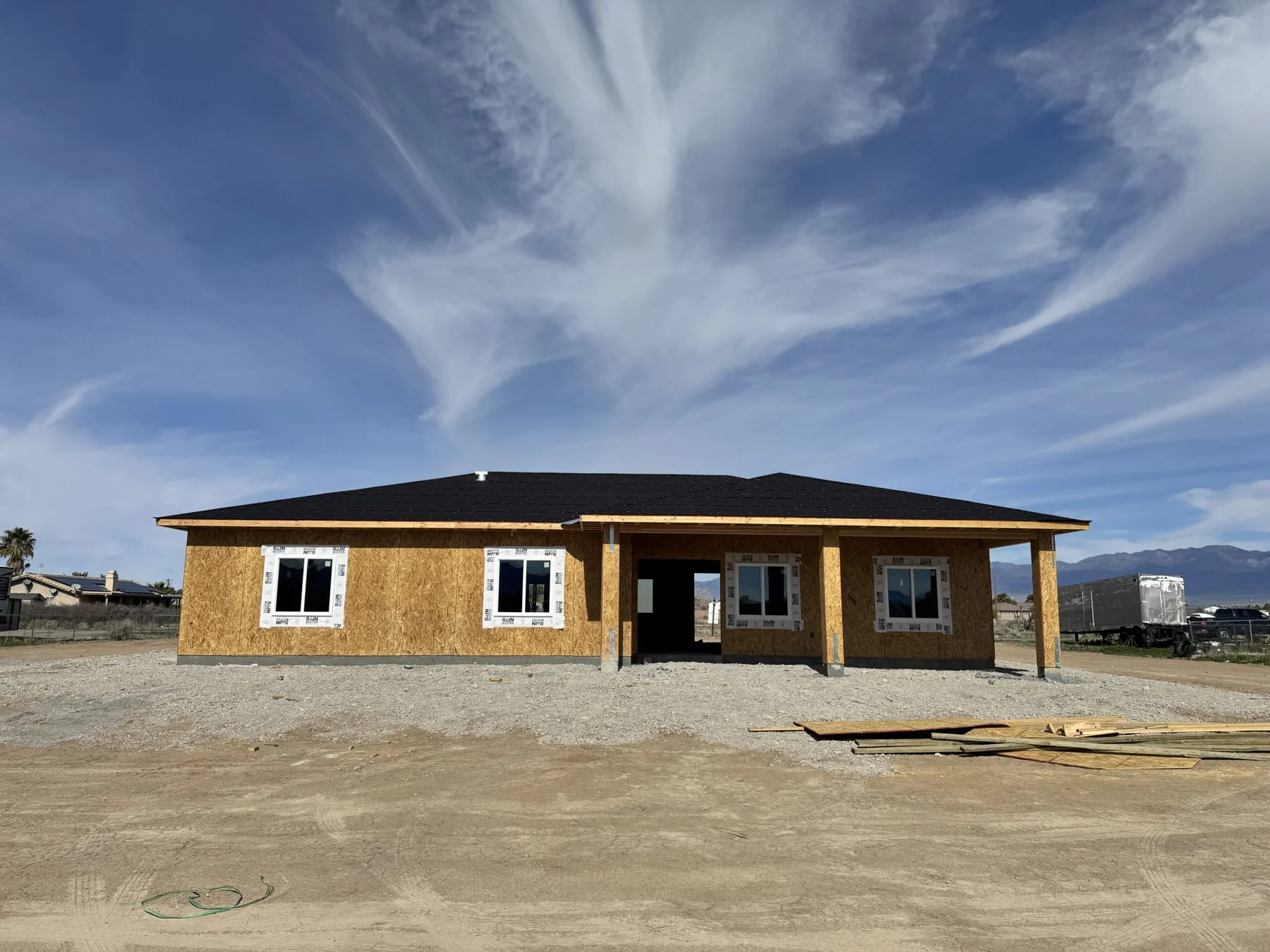

Framing is where your home starts to look like a home. Walls go up, roof trusses are set, and the structure takes shape. On a standard 1,900–2,500 square foot single-story home — the size range ICH builds — an experienced framing crew will typically complete rough framing in 3 to 4 weeks.

What affects framing speed:

  • Crew availability — Pahrump has a smaller subcontractor base than Las Vegas. Scheduling the right crew at the right time is something your builder manages on your behalf
  • Plan complexity — straightforward open-concept single-story plans frame faster than complex rooflines or multi-wing designs
  • Material lead times — lumber and truss delivery schedules affect start dates

Our homes are single-story, open-concept designs — which frame efficiently and reduce the risk of timeline variance during this phase.

Phase 4: Mechanicals — Rough-In (3–5 Weeks)

Once framing is complete and the building inspector signs off on rough framing, the mechanical trades go in — plumbing, electrical, and HVAC rough-in. These three trades often work in sequence with some overlap, and each requires its own inspection before walls can be closed.

This phase includes:

  • Plumbing rough-in (supply lines, drain lines, water heater location)
  • Electrical rough-in (panel, circuits, switch and outlet boxes)
  • HVAC rough-in (ductwork, air handler location, refrigerant lines)
  • Insulation installation
  • Rough mechanical inspections by Nye County

In the Pahrump climate, HVAC is not an afterthought — it’s a primary system. Homes here need to handle sustained summer temperatures above 110°F. ICH homes are sized appropriately for the desert environment, and we coordinate HVAC specs during the design phase rather than treating it as an afterthought at rough-in.

Typical duration: 3–5 weeks depending on trade scheduling and inspection turnaround.

Phase 5: Drywall, Finishes, and Cabinetry (5–8 Weeks)

This is the longest interior phase and where your home transforms from a shell into a finished living space. It includes drywall hang and finish, paint, flooring, cabinetry installation, countertops, trim, doors, plumbing fixtures, electrical fixtures, and appliance installation.

At ICH, our standard finishes are included — quartz countertops, luxury vinyl plank flooring throughout, stainless steel appliances, and modern cabinetry. These aren’t upgrades you need to price separately. Because we spec our homes consistently, our vendors know exactly what’s coming and can schedule delivery and installation without surprises.

This phase involves the most moving parts of the build:

  • Drywall — hang, tape, texture, and prime (1–2 weeks)
  • Paint — interior and exterior (overlaps with drywall finish)
  • Flooring — LVP throughout; no tile complications in ICH standard builds
  • Cabinetry installation — kitchen, bathrooms, laundry
  • Countertop templating and installation — quartz requires a template after cabinet install, then 1–2 weeks for fabrication
  • Plumbing and electrical trim-out — fixtures, switches, outlets
  • Appliance installation
  • Exterior finish work — covered patio, garage doors, landscaping prep

This phase is where most of the buyer-visible work happens — and where buyers start getting excited. We send regular updates during this phase so you’re never wondering what’s happening at your lot.

Typical duration: 5–8 weeks.

Phase 6: Final Inspections and Certificate of Occupancy (1–3 Weeks)

The finish line. Once construction is complete, Nye County performs final inspections across all trades — building, plumbing, mechanical, and electrical. If everything passes, the county issues a Certificate of Occupancy (C.O.), which is the legal document that says the home is safe and complete for occupancy.

In our experience, homes that are built to code from the start — with quality subcontractors and proper inspection scheduling — pass final inspections without major issues. Homes that cut corners during construction often face correction orders that add weeks to the timeline.

After C.O. issuance:

  • Final walkthrough with the buyer
  • Punch list items addressed (minor touch-ups, adjustments)
  • Keys transferred
  • You move in

Typical duration: 1–3 weeks from completion to C.O., depending on county inspection scheduling.

The Full Timeline at a Glance

Phase What Happens Typical Duration
Pre-Construction & Permits Plans, permits, financing 4–8 weeks
Site Work & Foundation Grading, well, septic, slab 3–5 weeks
Framing Walls, roof, structure 3–4 weeks
Mechanicals Rough-In Plumbing, electrical, HVAC 3–5 weeks
Finishes & Interior Drywall, flooring, cabinetry, fixtures 5–8 weeks
Final Inspections & C.O. Inspections, walkthrough, keys 1–3 weeks
Total Contract to keys 19–33 weeks (5–8 months)

The 6–10 month figure we publish accounts for real-world scheduling, weather, and inspection turnaround. A build that hits every phase cleanly can close in around 6 months. A build with a complex permit, a slow well, or supply chain delays on a specific material can push toward 10.

What Makes Pahrump Builds Unique

Building in Pahrump is different from building in a Las Vegas subdivision — and that’s largely a good thing for buyers who want control and space. But a few Pahrump-specific factors are worth knowing:

Wells. Las Vegas has municipal water. Pahrump doesn’t. Your well is drilled before construction begins, and depth varies significantly depending on where your lot sits in the valley. This is one of the most location-specific variables in a Pahrump build timeline.

Lot size. One-acre lots mean more grading, more trenching for utilities, and longer runs for electrical service from the road. It adds time relative to a small subdivision lot — but it’s also why you have an acre of land and no HOA.

Smaller subcontractor pool. Pahrump’s trades community is more limited than Las Vegas. An experienced local builder has existing relationships with reliable subs who know the area. A builder without local roots will spend time you don’t have finding and vetting trades.

Nye County inspections. The county inspection schedule is real and not always fast. A builder who schedules inspections correctly — not reactively — keeps the timeline moving. We’ve built enough homes in Nye County to know when to call and how to keep projects on track. You can see our current and past projects on our Properties page, including recent completed homes across the Pahrump Valley.

How ICH Manages the Timeline

We set realistic expectations from day one, then work to beat them. Here’s how:

  • Pre-permit checklist — we don’t sign contracts until the lot is evaluated and the plan is set. No surprises at permit submission.
  • Established subcontractor relationships — our trades know us and schedule us. We don’t wait in line.
  • Standard floor plans — our proven designs frame fast, inspect clean, and finish efficiently.
  • Regular buyer communication — you’ll know what’s happening at every phase, not just when something goes wrong.

If you’ve read our cost to build guide and understand where your budget lands, the next question is always the timeline. Now you have both. For a comparison of what new construction delivers versus buying an existing home, our new construction vs. resale breakdown is worth a read.

Why Choose Innovative Custom Homes

We build in Pahrump. Not occasionally — this is our market. We know Nye County’s permit process, we know the subcontractor relationships that matter, and we know what it takes to deliver a quality home on time in the desert.

Our most recent completed home at 1671 Iguana Street is a 3-bed, 3-bath, 1,904 square foot home on a full acre — built and delivered on schedule. Our next project at 3550 Margarita Avenue is currently under construction. These aren’t hypothetical builds — they’re real homes, built by real people, in the community we work in every day.

If you own land in Pahrump and want to know what your build timeline looks like specifically, or if you’re still looking for the right lot, reach out to us directly. We’ll give you straight answers on timeline, cost, and what to expect — no pressure, no runaround.

Frequently Asked Questions

How long does it take to get a building permit in Nye County?

Residential building permits in Nye County typically take 4 to 6 weeks from submission to approval for standard single-family home plans. Plans that require revisions or involve complex design elements can take up to 8 weeks. We handle the entire permitting process on your behalf.

Can you build year-round in Pahrump?

Yes. Pahrump’s desert climate allows for year-round construction. Winters are mild and rarely interrupt building schedules. Summer heat (July–August) can slow some exterior work and concrete pours, but it doesn’t stop construction — it just requires proper scheduling of heat-sensitive work to early morning hours.

What is a Certificate of Occupancy and why does it matter?

A Certificate of Occupancy (C.O.) is the official document issued by Nye County confirming the home has passed all required inspections and is legally approved for people to live in. You cannot move in, get homeowner’s insurance, or close a mortgage on a new home without it. We don’t hand over keys until the C.O. is in hand.

Does the timeline change if I’m building on my own lot vs. an ICH lot?

The active construction timeline is the same. The pre-construction phase may vary slightly depending on your lot’s condition — whether it needs additional clearing, soil testing, or has infrastructure already in place. Lots with existing utility access or a prior well tend to move faster.

What’s the biggest cause of delays in a Pahrump custom home build?

In our experience, delays most often originate in the pre-construction phase — incomplete plan sets, financing that isn’t finalized, or lot conditions that weren’t evaluated before contract signing. Once a build starts, the construction phases are predictable. The front end is where preparation makes the biggest difference.

How far in advance should I start the process if I want to be in my home by a specific date?

Work backward from your target move-in date by 8–10 months to be safe. That accounts for the permitting phase, full construction, and a buffer for any delays. If you want to be in your home by summer 2027, the conversation should start this fall.

Ready to Talk About Your Build?

Now you know what to expect. The timeline is real, the process is manageable, and the result — a brand-new custom home on a full acre in the Pahrump Valley — is worth every week of it.

Contact Innovative Custom Homes to start the conversation. We’ll walk you through what your specific lot and plan looks like on a timeline and give you a real number — not a range pulled from thin air.

Innovative Custom Homes | Pahrump, NV | (702) 684-2595 | Build With Us

Reset password

Enter your email address and we will send you a link to change your password.

Get started with your account

to save your favourite homes and more

Sign up with email

Get started with your account

to save your favourite homes and more

By clicking the «SIGN UP» button you agree to the Terms of Use and Privacy Policy
Powered by Estatik
